When the Sparks and the Pipes Need to Work Together at Wallumatta Rd, Newport | Scott Electrics

Most property upgrades involve at least two trades. But most of the time, those trades never actually talk to each other — one finishes, the other starts, and the homeowner manages the gap in between. At Wallumatta Road, Newport, that approach wasn’t an option. A simultaneous $18,000 electrical infrastructure overhaul and $11,720 sewer remediation were running on the same site, in the same ground, at the same time. Here’s how Scott Electrics and Pearla Plumbing & Electrical coordinated both scopes — and why that coordination saved the client significant money and time.


Two Major Infrastructure Projects, One Property, One Window

The Wallumatta Road property needed two things done urgently and at the same time.

On the electrical side, Scott Electrics was engaged to deliver a complete Level 2 infrastructure overhaul — a new private pole, 3-phase aerial service to replace aging mains that were encroaching on neighbouring boundaries, full asbestos switchboard remediation, sub-board relocation, and EV-ready capacity provisioning. A comprehensive $18,000 project scope.

On the plumbing side, Pearla Plumbing & Electrical had identified a primary terracotta branch sewer line beneath the dwelling that had suffered structural degradation — causing leaks and blockages in a downstairs bathroom. The pipework was encased in concrete, making traditional excavation high-risk and prohibitively expensive. Pearla’s scope included precision earthworks, concrete removal and structural trenchless pipe relining. An $11,720 project running through the same ground as the new electrical consumer mains.

Running these two scopes independently — with separate contractors, separate timelines and no shared site plan — would have been a recipe for conflict, rework and unnecessary cost. Running them together, from a single coordinated plan, was the correct answer.


The Underground Coordination Problem

The critical coordination point between the two scopes was below ground.

Scott Electrics’ new consumer mains — the underground cable run connecting the new private pole to the property’s main switchboard — had to be routed through the same zone as Pearla’s sewer remediation works. Underground service separation requirements under AS/NZS 3000 and the Plumbing Code of Australia specify minimum clearances between electrical conduits and sewer pipework. Those clearances are not negotiable and cannot be retrofitted after the fact.

If the two scopes had been managed independently, the realistic outcome would have been one of two things: the electrical mains run into a position that conflicted with the sewer works, requiring excavation and rerouting after the fact — or the sewer relining route compromised by the position of the electrical conduit, requiring additional earthworks.

Instead, both teams planned their underground routes together before either scope began. The consumer mains route and the sewer relining route were mapped against each other on a shared site plan, clearances were confirmed, and both trades executed within their allocated zones. No conflicts. No rework. No additional excavation.


What Pearla Plumbing Delivered on Site

While Scott Electrics managed the electrical scope, Pearla Plumbing’s team handled the sewer remediation — and the complexity of their scope is worth understanding, because it directly affected how the electrical works were sequenced.

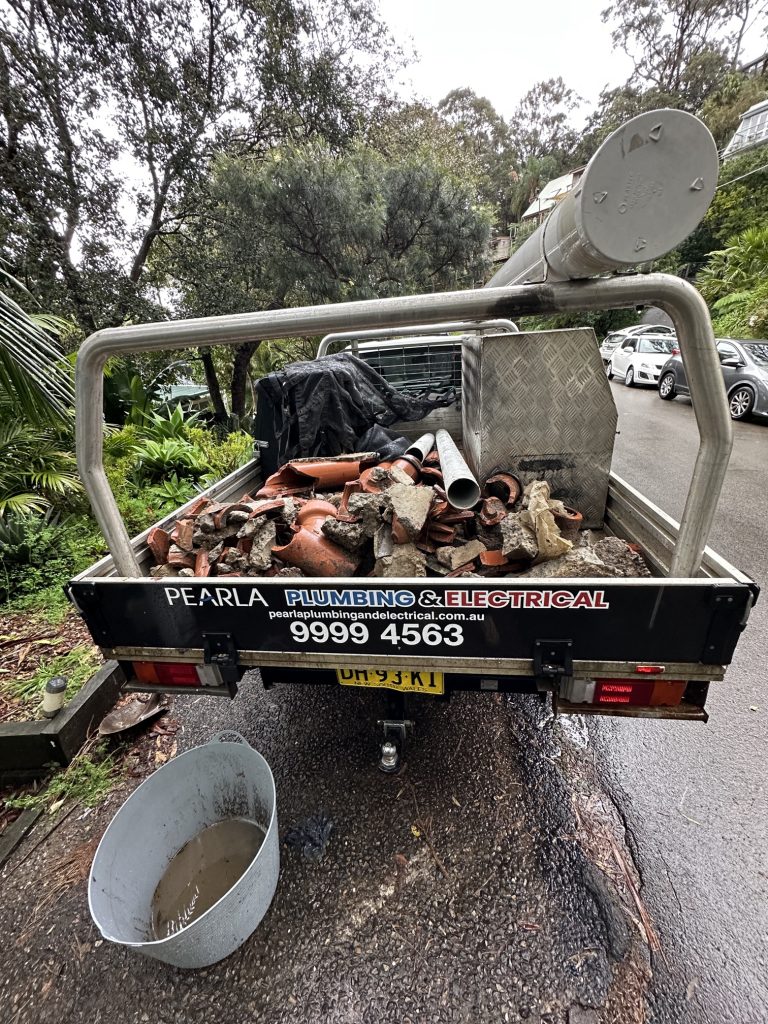

The degraded terracotta branch line was encased in concrete beneath the dwelling — not accessible without physical demolition. Pearla’s team jackhammered and removed 8 metres of concrete-encased earthenware pipework at the boundary to restore flow to the PVC main. This was precision earthworks in a confined area, with the new electrical consumer mains route running nearby.

Once flow was restored to the main line, Pearla performed a trenchless structural relining of 4 metres of remaining terracotta pipework — inserting a structural felt sleeve saturated with two-part epoxy resin and curing it in place to form a new pipe within the old one. No further excavation. No ground reinstatement across the full pipe run. A lifetime-guaranteed result that now exceeds Australian Standards for sewer infrastructure.

The trenchless relining phase was sequenced to follow the concrete removal earthworks — which in turn was coordinated with Scott Electrics’ underground mains pull so that both trades were working in adjacent zones simultaneously rather than sequentially.


Why This Is the Right Model for Complex Property Upgrades

The Wallumatta Road project is a clear example of why dual-trade coordination matters on complex residential infrastructure jobs — and why the traditional model of independent contractors managed separately by the homeowner produces worse outcomes.

Timeline. Running both scopes simultaneously compressed what would have been a multi-week sequential programme into a single coordinated site window. The homeowner wasn’t waiting for the plumber to finish before the electrician could start underground works.

Cost. Shared excavation and reinstatement windows meant the ground was opened once, both trades worked their underground runs, and the site was reinstated once. Sequential trades mean opening the ground twice — and paying for it twice.

Compliance. Underground service separation requirements between electrical conduits and sewer pipework were confirmed and documented from a single shared site plan. There was no ambiguity about who was responsible for maintaining clearances, because both trades were working from the same drawing.

Single point of contact. The homeowner dealt with one coordinated team for a $29,720 infrastructure upgrade spanning two licensed trades and two regulatory frameworks. One site manager. One compliance documentation package. One completion sign-off.


The Scott Electrics Scope at Wallumatta Road — A Summary

For context on the electrical side of the Wallumatta Road project:

  • New private pole and 3-phase aerial service — resolving boundary encroachment of existing aerial mains and upgrading from single-phase to 3-phase capacity
  • Asbestos switchboard remediation — safe removal and disposal of the legacy asbestos-backed panel and ceramic fuse system under NSW SafeWork protocols
  • Sub-board relocation — full reconfiguration and relocation of sub-circuit wiring to an internal sub-board for improved emergency accessibility
  • EV-ready provisioning — dedicated circuit and consumer mains sizing to support future EV charger installation without additional mains works
  • Consumer mains underground run — coordinated with Pearla’s sewer remediation scope throughout

What to Consider If Your Property Needs Both Electrical and Plumbing Works

If you’re planning a major property upgrade that involves both electrical infrastructure and plumbing or drainage works, the questions worth asking your contractors upfront are:

Are any underground services running in the same zone? Consumer mains, sewer lines, stormwater drainage and gas lines all require separation distances from each other. If multiple underground services are being installed or upgraded, they need to be planned together.

Can both scopes run simultaneously? Sequential trades extend your programme and your disruption window. If both scopes can be planned together, they can usually run simultaneously — saving time and often money on shared earthworks.

Who is coordinating between trades? On a complex infrastructure project, someone needs to own the site coordination. If that’s the homeowner, the risk of conflicts and rework sits with them. If it’s a dual-trade team with a shared site plan, it sits with the contractors — where it belongs.

Is there a single compliance package at the end? A coordinated dual-trade project should produce a single compliance documentation set — electrical certificates, plumbing compliance certificates and any relevant SafeWork documentation — rather than two separate paper trails the homeowner has to manage and store.


About the Scott Electrics and Pearla Plumbing Partnership

Scott Electrics and Pearla Plumbing & Electrical operate as a dedicated dual-trade partnership across Sydney’s Northern Beaches and Eastern Suburbs. Both companies are independently licensed — Scott Electrics as a Level 2 ASP and licensed electrical contractor, Pearla as a licensed plumbing and drainage contractor — and work from shared site plans on projects where both scopes are required.

For property owners on the Northern Beaches, Eastern Suburbs or North Shore planning major infrastructure upgrades, the partnership offers a single point of contact for electrical and hydraulic works, coordinated timelines, and unified compliance documentation.
